Council Agenda item 9J
Change Order #1, 2025-2027 Pavement Markings
City Council, Monday, June 23, 2025
Download these 4 pages, 1.0 MB Whole packet, 178 pages, 14.7 MB
Page 68
Text of page 68

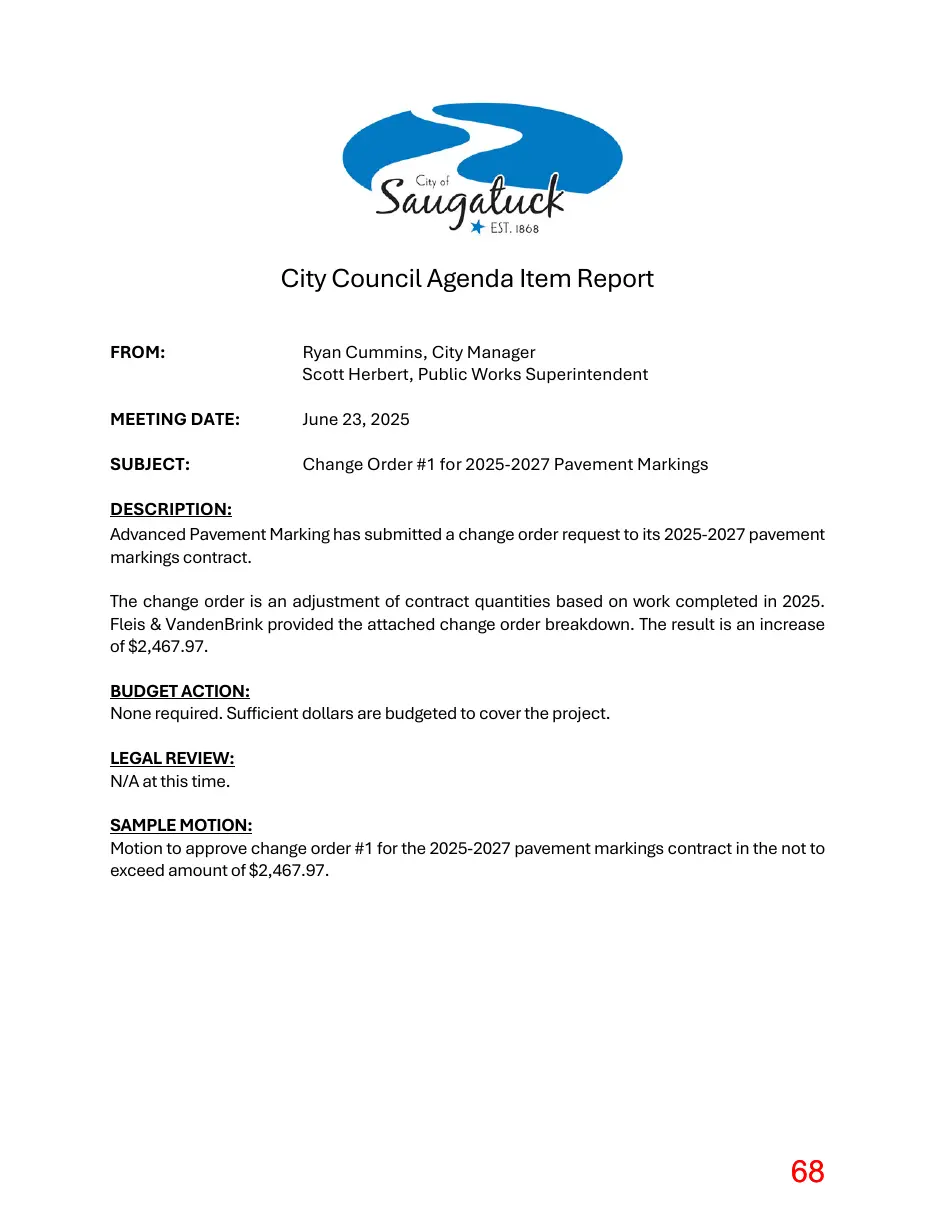

City Council Agenda Item Report FROM:
Ryan Cummins, City Manager Scott Herbert, Public Works Superintendent
MEETING DATE:
June 23, 2025
SUBJECT:
Change Order #1 for 2025-2027 Pavement Markings
DESCRIPTION: Advanced Pavement Marking has submitted a change order request to its 2025-2027 pavement markings contract. The change order is an adjustment of contract quantities based on work completed in 2025. Fleis & VandenBrink provided the attached change order breakdown. The result is an increase of $2,467.97. BUDGET ACTION: None required. Sufficient dollars are budgeted to cover the project. LEGAL REVIEW: N/A at this time. SAMPLE MOTION: Motion to approve change order #1 for the 2025-2027 pavement markings contract in the not to exceed amount of $2,467.97.
Page 69
Text of page 69

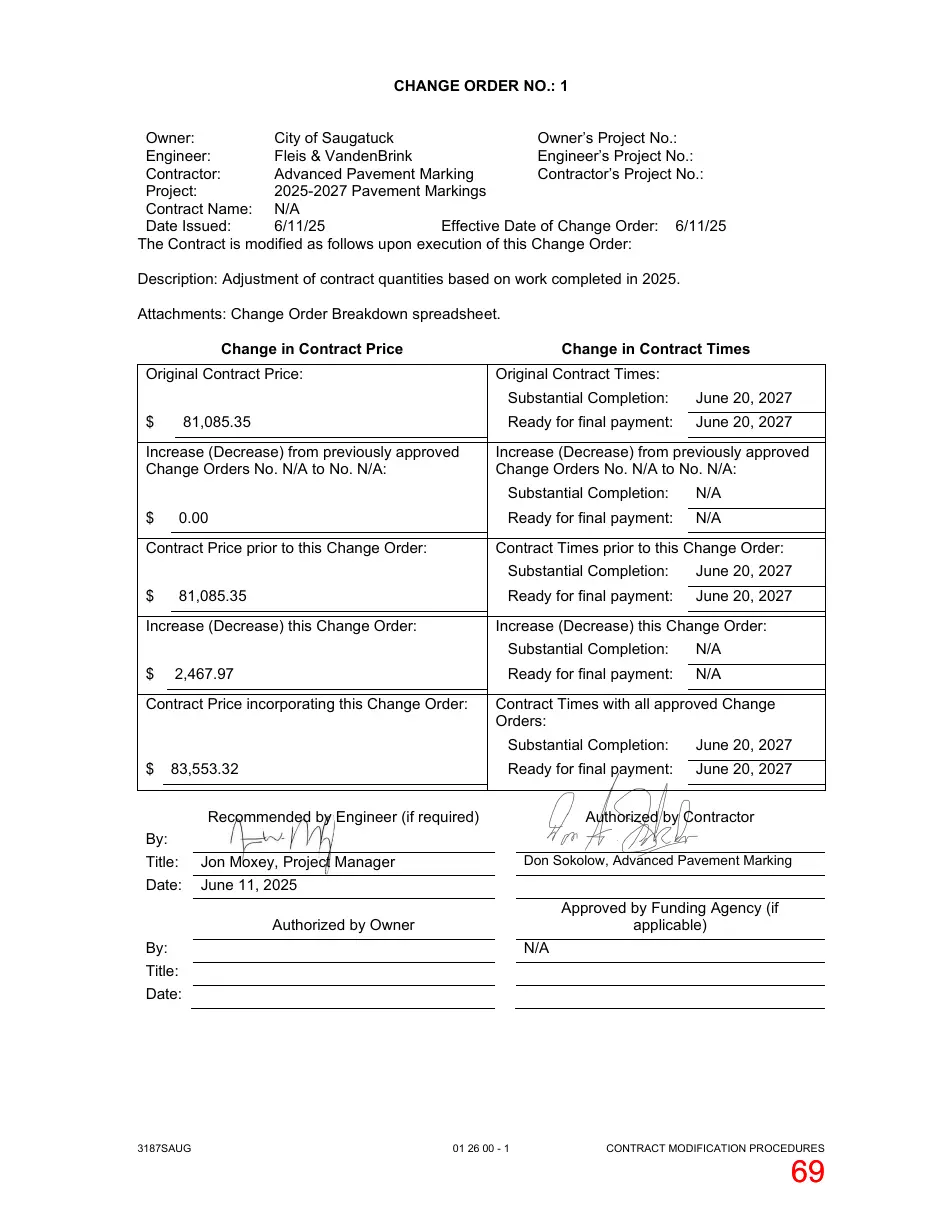

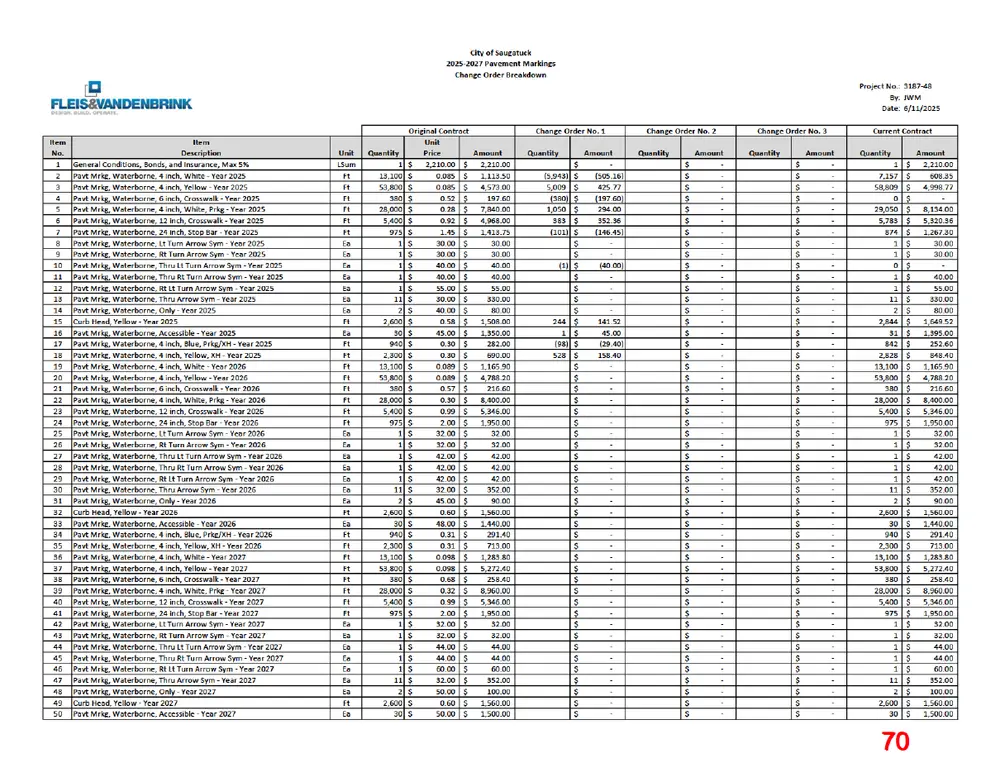

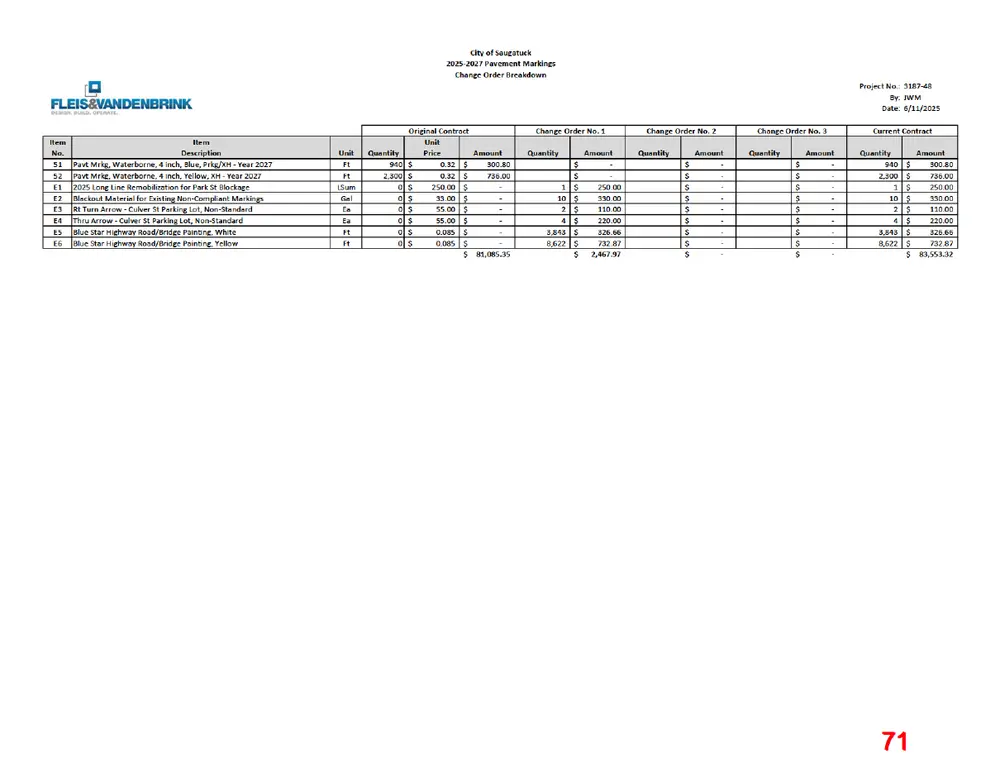

CHANGE ORDER NO.: 1 Owner: City of Saugatuck Owner’s Project No.: Engineer: Fleis & VandenBrink Engineer’s Project No.: Contractor: Advanced Pavement Marking Contractor’s Project No.: Project: 2025-2027 Pavement Markings Contract Name: N/A Date Issued: 6/11/25 Effective Date of Change Order: 6/11/25 The Contract is modified as follows upon execution of this Change Order: Description: Adjustment of contract quantities based on work completed in 2025. Attachments: Change Order Breakdown spreadsheet. Change in Contract Price
Change in Contract Times
Original Contract Price: $
Original Contract Times:
81,085.35
Increase (Decrease) from previously approved Change Orders No. N/A to No. N/A: $
0.00
Contract Price prior to this Change Order: $
81,085.35
Ready for final payment:
June 20, 2027
Increase (Decrease) from previously approved Change Orders No. N/A to No. N/A: Substantial Completion:
N/A
Ready for final payment:
N/A
Substantial Completion:
June 20, 2027
Ready for final payment:
June 20, 2027
Increase (Decrease) this Change Order:
2,467.97
Contract Price incorporating this Change Order:
June 20, 2027
Contract Times prior to this Change Order:
Increase (Decrease) this Change Order: $
Substantial Completion:
83,553.32
Substantial Completion:
N/A
Ready for final payment:
N/A
Contract Times with all approved Change Orders: Substantial Completion:
June 20, 2027
Ready for final payment:
June 20, 2027
Recommended by Engineer (if required)
Authorized by Contractor
By: Title:
Jon Moxey, Project Manager
Date:
June 11, 2025
Don Sokolow, Advanced Pavement Marking
Approved by Funding Agency (if applicable)
Authorized by Owner By:
N/A
Title: Date:
3187SAUG
01 26 00 - 1
CONTRACT MODIFICATION PROCEDURES
