Council Agenda item 9C
Change Order #1 for Mt. Baldhead Restroom Replacement
City Council, Tuesday, May 27, 2025
Download these 2 pages, 723 KB Whole packet, 188 pages, 16.0 MB
Page 7

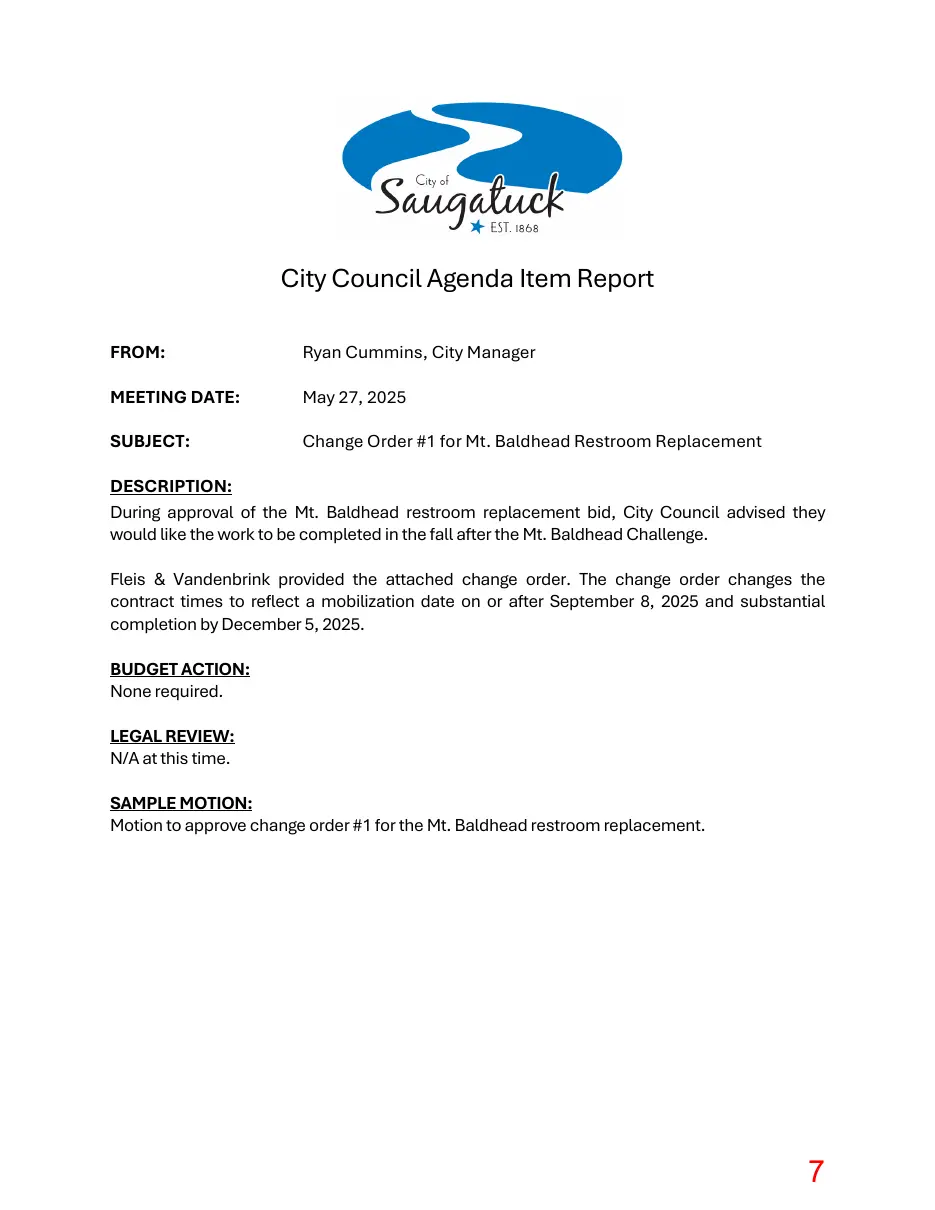

Text of page 7
City Council Agenda Item Report FROM:
Ryan Cummins, City Manager
MEETING DATE:
May 27, 2025
SUBJECT:
Change Order #1 for Mt. Baldhead Restroom Replacement
DESCRIPTION: During approval of the Mt. Baldhead restroom replacement bid, City Council advised they would like the work to be completed in the fall after the Mt. Baldhead Challenge. Fleis & Vandenbrink provided the attached change order. The change order changes the contract times to reflect a mobilization date on or after September 8, 2025 and substantial completion by December 5, 2025. BUDGET ACTION: None required. LEGAL REVIEW: N/A at this time. SAMPLE MOTION: Motion to approve change order #1 for the Mt. Baldhead restroom replacement.
Page 8

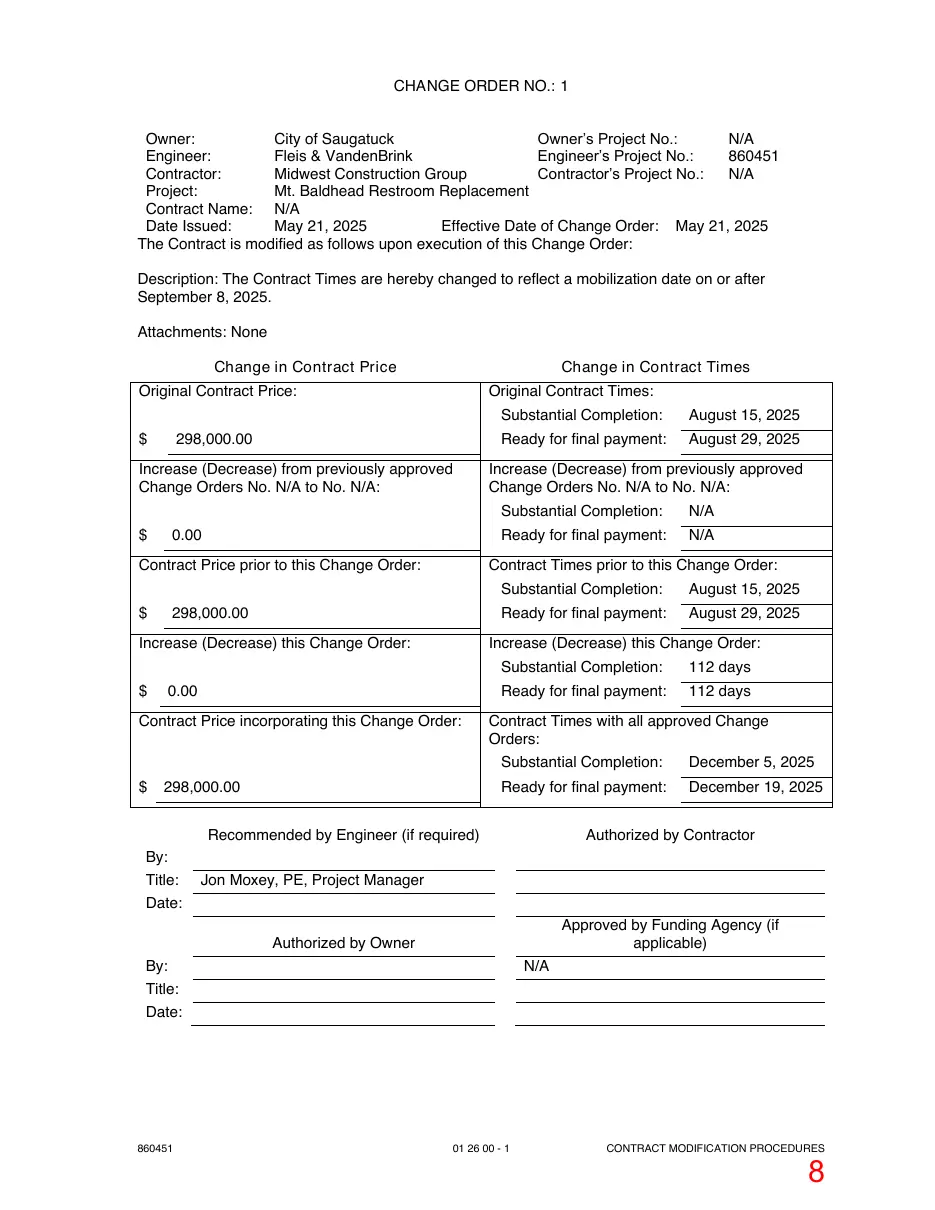

Text of page 8
CHANGE ORDER NO.: 1 Owner: City of Saugatuck Owner’s Project No.: N/A Engineer: Fleis & VandenBrink Engineer’s Project No.: 860451 Contractor: Midwest Construction Group Contractor’s Project No.: N/A Project: Mt. Baldhead Restroom Replacement Contract Name: N/A Date Issued: May 21, 2025 Effective Date of Change Order: May 21, 2025 The Contract is modified as follows upon execution of this Change Order: Description: The Contract Times are hereby changed to reflect a mobilization date on or after September 8, 2025. Attachments: None Change in Contract Price
Change in Contract Times
Original Contract Price: $
Original Contract Times:
298,000.00
Increase (Decrease) from previously approved Change Orders No. N/A to No. N/A: $
0.00
Contract Price prior to this Change Order: $
298,000.00
Ready for final payment:
August 29, 2025
Increase (Decrease) from previously approved Change Orders No. N/A to No. N/A: Substantial Completion:
N/A
Ready for final payment:
N/A
Substantial Completion:
August 15, 2025
Ready for final payment:
August 29, 2025
Increase (Decrease) this Change Order:
0.00
Contract Price incorporating this Change Order:
August 15, 2025
Contract Times prior to this Change Order:
Increase (Decrease) this Change Order: $
Substantial Completion:
298,000.00
Substantial Completion:
112 days
Ready for final payment:
112 days
Contract Times with all approved Change Orders: Substantial Completion:
December 5, 2025
Ready for final payment:
December 19, 2025
Recommended by Engineer (if required) By: Title: Date:
Authorized by Contractor
Jon Moxey, PE, Project Manager Approved by Funding Agency (if applicable)
Authorized by Owner By: Title: Date:
860451
N/A
01 26 00 - 1
CONTRACT MODIFICATION PROCEDURES
